Transportation Issues

Still the 'Good Roads State'?

With more than $5 billion in highway construction
in progress, the N.C. DOT is building new roads
as fast as it can. But is it miles enough soon enough?

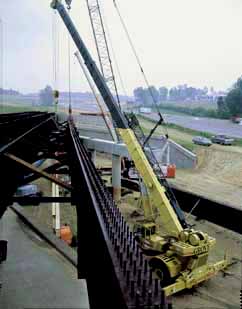

Above, the $120 million Neuse River Bridge at New Bern opened last September. Below right, the new I-85 Bypass at I-40 just east of Greensboro should be completed in three years at a cost of $275 million.

By Richard Rogoski

From the mountains to the coast, North Carolina is experiencing phenomenal growth in people and their cars. And the state Department of Transportation is trying to stay ahead of the traffic curve by systematically widening existing highways and building new ones as fast as it can.

It all comes at a price, of course, which in this case starts at $3.95 billion. That's the amount tied up in the N.C. DOT's 10 largest highway projects now under construction. The tab rises to more than $5 billion when you add the $1.2 billion spent last year for resurfacing nearly 1,700 miles of primary and secondary highways, replacing 68 substandard bridges, and installing 405 miles of median guardrails.

The purpose? To maintain the state's 78,000 miles of highways -- only Texas has more -- and to hold on to North Carolina's reputation as "The Good Roads State." How the DOT thinks it can solve the state's traffic problems can be seen in the new construction projects, all of which are designed to help the state cope with the surge in population. Here is an overview:

* The Charlotte Outer Loop
*
The Raleigh Outer Loop
*
Interstate 26 Connector
*
Greensboro Bypass, I-40 Widening
*
I-85 in Rowan County
*
Bypasses Around Jacksonville, Wilson, Manteo
*
U.S. 74 Bypass at Rockingham
Also: Five Recently Completed Projects

The Charlotte Outer Loop

With a price tag of more than $1.2 billion, I-485, as the loop is known, is being built in sections, explains Calvin Leggett, director of planning and programming for the NCDOT. The first 26-mile section, which makes up the southern arc of the loop, has already been constructed. But the entire loop, totaling about 65 miles, is not scheduled for completion until some time between 2006 and 2013 -- even though the first contract for the project was let in May 1988, Leggett says. And while this project is high on the DOT's list of priorities, there are still some sections of roadway that have yet to be budgeted for, Leggett admits.

Rapid and continued growth in the Charlotte area has made an outer loop a necessity, Leggett notes. So when it's completed, it will "provide a bypass for I-77 and allow traffic to go around Charlotte," he says. Additionally, it will serve as a bypass for U.S. 74 and also will help connect those communities that have developed on the outskirts of the city, Leggett adds.

Yet the prospect of having to wait another six years or more for the outer loop to be completed is disconcerting for many Charlotte officials and business leaders. "We need it sooner than later," says Bob Morgan, group vice president for public policy at the Charlotte Chamber of Commerce. "Charlotte is the largest metropolitan area in the U.S. without an outer loop."

While Morgan agrees that I-485 will provide "additional highway capacity to get around Charlotte," he also says it will provide surrounding areas with additional access "into" Charlotte. And since 100 percent of the outer loop will be in Mecklenburg County and 80 percent within the Queen City, the loop is destined to have an even greater economic impact on Charlotte and surrounding areas since it will serve as a magnet for business development. "Every time you finish a segment, it opens up a new submarket," Morgan says.

However, Morgan dismisses critics who say the outer loop will detract from the inner city and lead to suburban development. "Our central business district is not in decline," he says. "And if you have an outer loop, that becomes the defining line for suburban development." He also cites a recent Federal Highway Authority study: "Cities without loops have more suburban sprawl than those with loops," Morgan says.


The Raleigh Outer Loop

Raleigh has been wrestling with the pros and cons of an outer loop since 1992, when the DOT awarded its first contract. With cost estimates now reaching $1.2 billion, Raleigh's outer loop, or I-540, is in a virtual dead heat with Charlotte's loop as the most expensive road project under construction. But when it's finally completed sometime in 2025, Raleigh's loop will be a six-lane, 71-mile highway that will encircle the Capital City well outside of the existing I-440 beltline.

Raleigh's outer loop is being constructed in segments that will eventually come together to complete the circle. With construction moving in an easterly direction, part of the roadway, designated the Northern Wake Expressway, already has been built from I-40 to Leesville Road. Three other segments of this northern arc -- one running from Leesville Road to Creedmoor Road; one running from Creedmoor to Six Forks Road; and one linking Six Forks with Falls of Neuse Road -- should be open by the end of this year, Leggett says.

According to Leggett, I-540 will eventually serve as a true loop, rather than doubling as a bypass the way Charlotte's I-485 will. But he admits it also will help relieve congestion on radial roads leading to I-440 and along some stretches of I-40 -- which has become notorious for rush-hour traffic jams in the vicinity of Research Triangle Park. In addition, it will provide North Raleigh residents with a more direct route to RTP and Raleigh-Durham International Airport, he says.

Harvey Schmitt, president and CEO of the Greater Raleigh Chamber of Commerce agrees. "It increases the whole mobility of northern Wake County." It's also serving as a magnet for residential and commercial growth, he says. "Any time you have a major transportation corridor, you open up opportunities for business development. People and businesses tend to cluster around major transportation routes."

But even those northern sections of Raleigh's outer loop that are not yet open are driving development. Wakefield Plantation, for example, is a 2,200-acre development located between North Raleigh and the town of Wake Forest that will be served by a section of I-540 scheduled to open in 2002. The upscale community features a Tournament Players Club golf course, homes with price tags hitting $2 million and 500 acres of commercial space that already has become one of the hottest addresses in the Triangle.


Interstate 26 Connector

While outer loops can serve dual functions, the DOT is working on a number of widening and road-building projects that will ultimately increase traffic flow and bring greater economic development to nearby cities and towns. But in the case of Interstate 26, the state's economy also will get a boost.

A new 30-mile connector road is being constructed from the town of Mars Hill to the Tennessee line. Located northeast of Asheville, the new thoroughfare will be an extension of I-26 and will create a more direct and safer route between Johnson City, Tenn., and Asheville. "The existing I-26 is a winding, two-lane highway," Leggett says. "The new one will be a four-lane highway."

Leggett says that many manufacturing plants in the Midwest truck their products through the mountains and across North Carolina to the Port of Wilmington. Opening a new route will improve access through the mountains and reduce the truck traffic on I-40, he says. Although the cost of this project is $330 million, 80 percent of the bill will be picked up by the federal government, Leggett says.


Greensboro Bypass, I-40 Widening

The area around Greensboro also gets its share of truck traffic. But two projects should help ease congestion. The Greensboro I-85 Bypass will be a 14.7-mile road tying together I-40 and I-85 in eastern Guilford County with I-85 just southwest of Greensboro (photo, left).

The first contract for this project was let in September 1997, and the bypass should be completed in 2003 at a total cost of about $275 million, Leggett says. When completed, it will allow regional traffic to flow around Greensboro while still affording local traffic the opportunity to drive downtown.

Another project that will impact the Greensboro area is the widening of I-40 from Greensboro to Winston-Salem. Although this project actually began in May 1993 when the first contract was awarded, it isn't scheduled to be completed until September 2002. Its cost: about $235 million. Motorists who regularly travel this stretch of I-40 have gotten used to the traffic snarls and barricades but it won't be long before this 10.9-mile length of interstate is transformed from four lanes to eight.

Penny Whiteheart, interim president for economic development at the Greensboro Area Chamber of Commerce, says both road projects will benefit Greensboro. She says the I-40 widening project will bolster the economies of both Greensboro and Winston-Salem by increasing the capacity along I-40, but Whiteheart sees the I-85 Bypass as having a more direct impact on Greensboro. "The I-85 Bypass will open up the southern part of Guilford County," she says.

Whiteheart says Greensboro will extend water and sewer lines to the county's southeastern part as a way to facilitate residential development. She adds that the availability of water and sewer, combined with the I-85 Bypass, also will facilitate commercial growth in that area.

Plus, the I-85 Bypass that is now under construction will eventually become part of a loop around Greensboro. As to when this loop will be completed, however, Whiteheart can only guess. One-half of the loop's western segment should be completed in 2005, she says. But the second half is not even on the DOT's five-year plan.


I-85 in Rowan County

Another DOT project involving I-85 is in Rowan County, just northeast of Charlotte. Approximately 13.2 miles of this road are being widened from four lanes to eight at a cost of $200 million. With the first contract having been awarded in June 1997, this project should be completed in 2005. The most important reason for widening this stretch of I-85 is simply to relieve traffic congestion. "That whole corridor is overburdened," Leggett says.

The problem actually begins just south of Lexington where the merging of U.S. 52, I-85 and Business I-85 means that 10 lanes of traffic are merging at a single point, Leggett says. The widening of I-85 in Rowan County also means the Yadkin River Bridge will have to be replaced, according to Leggett, who also notes that similar congestion occurs around China Grove in the southern part of the county. And Salisbury isn't much better.

According to John Casey, chairman of the local affairs committee at the Rowan County Chamber of Commerce, the widening of I-85 is necessary to keep up with the growth his county is experiencing. "This area is growing very fast because of its proximity to Charlotte," he says. But Casey also says the widening of I-85 needs to continue into neighboring Cabarrus County to avoid a bottleneck there. "You'll be going from three lanes to eight lanes, then down to two lanes in Cabarrus County," he says.


Bypasses Around Three Eastern Cities

Traffic congestion and converging highways also has led the DOT to begin building the Jacksonville Bypass. Served by U.S. 17 and N.C. 24, the city of Jacksonville borders the northern part of Camp Lejeune Marine Corps Base. The 7.4-mile bypass, which will link with U.S. 17, is scheduled for completion in 2005 at an estimated cost of $140 million. Work began in March 1998 with the awarding of the first construction contract.

Another bypass now under construction in the eastern part of the state will help relieve congestion in and around Wilson. The 13.4-mile Wilson Bypass will allow east- and west-bound traffic on U.S. 264 to avoid town. "The existing U.S. 264 was built in the 1950s and now is a commercial strip," Leggett says. "It's literally a city street there."

Since U.S. 264 also serves as a major connector between Raleigh and Greenville, the new bypass will allow for the free flow of through traffic, he adds. The first contract was let in November 1995, and this $125 million project is scheduled for completion in 2003.

The growing popularity of coastal towns and beaches has taken its toll on both residents and tourists. That's why the DOT decided to build a bypass around the Dare County town of Manteo, which is located on the Croatan Sound side of Roanoke Island. U.S. 264 and U.S. 64 merge near Manns Harbor, where they form a single roadway that serves both Manteo and Nags Head. But the new 10-mile, $125 million bypass that will be located just south of Manteo will link U.S. 264 with U.S. 64 at N.C. 345.

And while traffic congestion in this area is the main reason for building this bypass, Leggett says it will also serve as an additional hurricane evacuation route. This project, which had a start date of March 1998, is scheduled for completion in 2002.


U.S. 74 Bypass at Rockingham

Bisecting Rockingham and Hamlet, U.S. 74 is a major route to Wilmington. But traffic congestion around these two towns is compounded because U.S. 1 and U.S. 220 also converge in Rockingham. Yet the real problem is U.S. 74, which constitutes the only two-lane segment left in this major highway system. In order to allow high-speed regional traffic on U.S. 74 to circumvent both towns, the DOT is constructing a 13.1-mile bypass just south of each town.

The first contract was awarded in December 1996 and the project should be completed by January 2001. And even though this bypass carries a $120 million price tag, it will become part of the I-74, I-73 corridor -- an interstate system that eventually will link Detroit to Charleston, S.C., by cutting diagonally across North Carolina, Leggett says.

Under the National Highway System Designation Act of 1995, the U.S. Department of Transportation labeled this corridor a high-priority project. But it's up to each state involved to either build new roads or bring existing roads up to federal highway standards. In the majority of cases, North Carolina has been able to use existing highways like U.S. 220, U.S. 74, U.S. 73, U.S. 311 and U.S. 52 as links to highways in adjoining states.

Beginning in Detroit, the I-74 and I-73 corridor runs through Cincinnati and Portsmouth, Ohio, then heads south through the Triad and into Rockingham. At Rockingham, I-73 will turn southwest into South Carolina, then head east toward Florence and Charleston. I-74, however, will continue to head southeast toward Charleston.

According to DOT projections, most of the North Carolina portion of this interstate system should be open between 2005 and 2010.


Five Recently Completed Road Projects

Highway road projects do get finished. The DOT has recently completed five major projects, the most spectacular being the Neuse River Bridge, which is pictured on the cover of this issue of the magazine. It opened last September at a cost of $119.5 million. The view in the photo at left looks from New Bern over the river toward Havelock.

Neuse River Bridge.
Distance: 1.5 miles.
Year Let: 1995.
Completion Date: September 1999.
Cost: $119.5 million.

U.S. 64 (Edgecombe County to Martin County).
Distance: 20.1 miles.
Year Let: 1995.
Completion Date: November 1999.
Cost: $94.2 million.

Interstate 74 (I-77, U.S. 52 connector).
Distance: 12.8 miles.
Year Let: 1991.
Completion Date: December 1999.
Cost: $83.6 million.

I-485 (Charlotte Outer Loop).
Distance: 1.74 miles.
Year Let: 1996.
Completion Date: April 2000.
Cost: $23.3 million.

US 264 Bypass.
Distance: 3.32 miles.
Year Let: 1998.
Completion Date: May 1999.
Cost: $22.5 million.
